ClockSunday, 05/07/2026 12:44

Berth No.4 of Chan May Port to Come Into Operation in Early September 2026

HNN.VN - This was the information announced on the morning of July 4 by Mr. Tran Dinh Quoc, Supervising Engineer at VSICO Maritime JSC (VSICO), the investor of Chan May Port Berths No.4 and No.5 General Cargo and Container Terminal Project.

38,000 visitors arrive in Lang Co during the event honoring the world beautiful bayNearly 1,400 runners take part in the Chan May - Lang Co running race 2026Ensuring tourism environment during the “Lang Co - World Beautiful Bay” programReviewing and Inspecting Project Progress at Chan May - Lang Co Economic ZoneConstruction begins on social housing project in Chan May

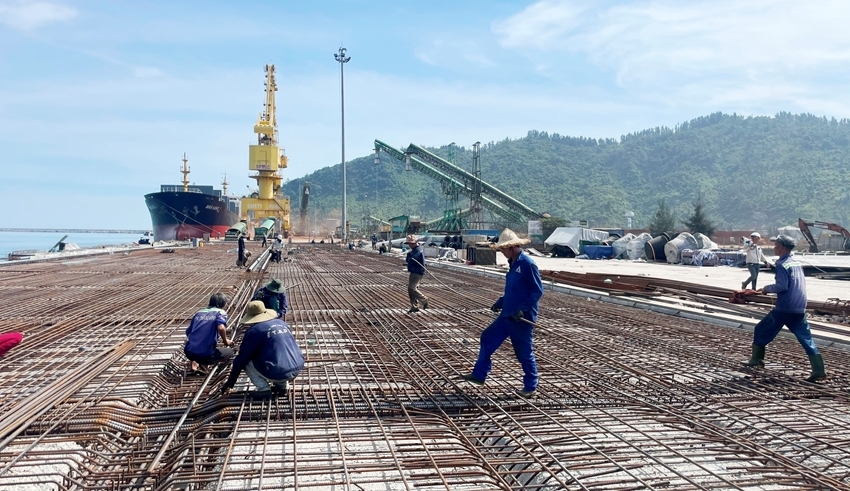

 Workers are racing to complete the construction of Berth No.4

According to Mr. Tran Dinh Quoc, several key components of Chan May Port Berths No. 4 and 5 General Cargo and Container Terminal Project have made significant progress.

At Berth N0.4, construction of the temporary Geotube seawall, installation of prefabricated vertical drains, ground reclamation, and dredging of the berth basin have all been completed. All 500 foundation piles for the wharf have been driven. Meanwhile, all 1,077 precast concrete components have been manufactured, with 786 units installed, representing 73% of the total construction. Furthermore, construction of the wharf deck has reached 4,500 m2 out of 10,800 m2, reaching about 45% of the planned volume.

Production of the two multipurpose quay cranes has also been completed, while construction of the yard foundation and drainage system is progressing simultaneously. Under the project schedule, Berth 4 is expected to be completed and come into operation on September 10.

Also being developed by VSICO JSC, Berth No.5 has so far completed the installation of 6 test piles and the fabrication of 17 out of 374 precast girders, equivalent to 4.5% of the planned volume. However, large-scale construction has yet to commence due to unresolved site clearance issues involving an underground petroleum pipeline serving the Chan May Fuel Depot operated by PVOIL, as well as the navigation channel used by fishing vessels on the Lach Giang River.

VSICO JSC has called on the Management Board of the Economic and Industrial Zones and Hue City People’s Committee to step in and support the contractor in hastening the project’s implementation so that it can be completed and put into operation in October 2028.

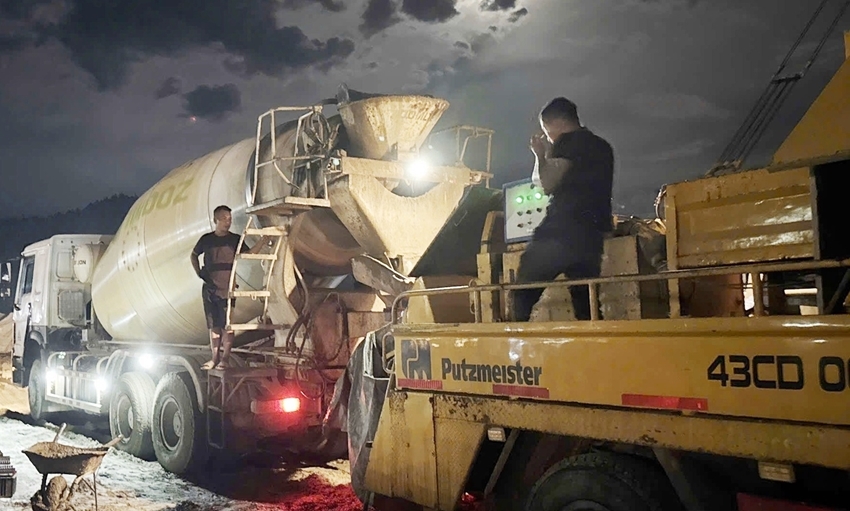

Implementing night-time construction to speed up the completion of the access road to Chan May Port’s Berth No.4

Chan May Port Berths No. 4 and No. 5 General Cargo and Container Terminal Project received investment policy approval from the Management Board of Hue City’s Economic and Industrial Zones under Decision No. 161/QD-KKTCN, dated October 6, 2022.

The project has a total investment of over VND 1.678 trillion and covers an area of 20.4 hectares. Under the approved design, the two berths will have a combined length of 540 meters and will be equipped with wharf infrastructure, warehouses, storage yards, technical infrastructure, machinery and equipment to provide cargo handling, warehousing… Once completed, the facilities will be capable of accommodating general cargo vessels of up to 70,000 deadweight tons and container ships of up to 4,000 TEUs.

By Minh Van
